Bridge built in record time after 2021 floodwaters

MC-Bauchemie's special-purpose resin MC-DUR LF 680 was used for the construction of two new bridges in Weilerswist and Blankenheim.
New bridge building in record time in flood-affected areas

Germany

Devastating storms caused floods and landslides in western Germany in July 2021, resulting in massive damage to the transport infrastructure. The remedial work included the construction in record time of two new bridges. Because these needed to be waterproofed in the depths of winter, the authorities opted for MC's special-purpose resin MC-DUR LF 680.

In the western regions of Germany affected by the flood disaster, reconstruction of the transport infrastructure was a high priority. In mid-August 2021, the roads and transport agency of the state of North Rhine-Westphalia, “Straßen NRW”, commissioned the company Gebr. Echterhoff with the reconstruction of two destroyed bridge structures, the Lommersum Bridge in Weilerswist and a cycle path bridge near Blankenheim, where repairs were no longer possible. It was important to those responsible to remedy the traffic disruptions as quickly as possible and, in particular, to complete the new bridges before Christmas.

New bridges opened within four months

The planning and approval work for both new bridge projects began in mid-August 2021. Thanks to the Echterhoff Express Bridge System, in which fully prestressed, precast concrete elements are manufactured off-site for on-site assembly as building blocks, the new bridges were successfully completed and released for use by December 2021.

Bridge waterproofing in the depths of winter

Echterhoff commissioned the company KEMNA BAU Andreae GmbH & Co. KG – ZN Sonderbau West with the waterproofing and mastic asphalt work, which had to be carried out in December 2021 at temperatures below 8 °C and in the presence of high air humidity and component moisture levels. Since the epoxy resin products usually specified for such work cannot be used in such adverse weather conditions without adverse side reactions, the special-purpose resin MC-DUR LF 680 was selected for the waterproofing work, with the public authority client, the Federal Highway Research Institute, and MC working in close collaboration. The MC resin can be used as a primer, scratch filler and sealer at temperatures as low as 2 °C and, above all, under conditions of high air humidity and component moisture. The translucent red resin cures very quickly and is resistant to high temperatures, making it ideal for use in conjunction with welding membranes. At 20 °C and a relative humidity of 50 %, MC-DUR LF 680 has an overworking time of one hour, while at 2 °C it is approx. two and a half hours, which means that sealing and waterproofing work can also be performed in autumn and winter.

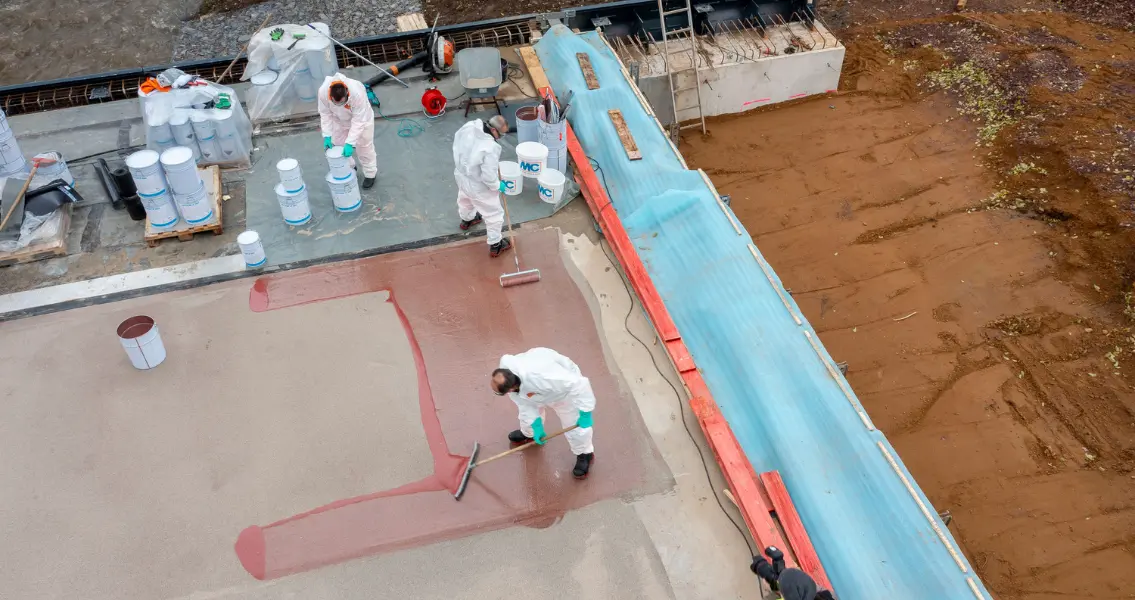

The climatic conditions were very demanding, with air temperatures below 8 °C and high humidity in the air and in the building components.

The climatic conditions were very demanding, with air temperatures below 8 °C and high humidity in the air and in the building components.
© MC-Bauchemie 2025

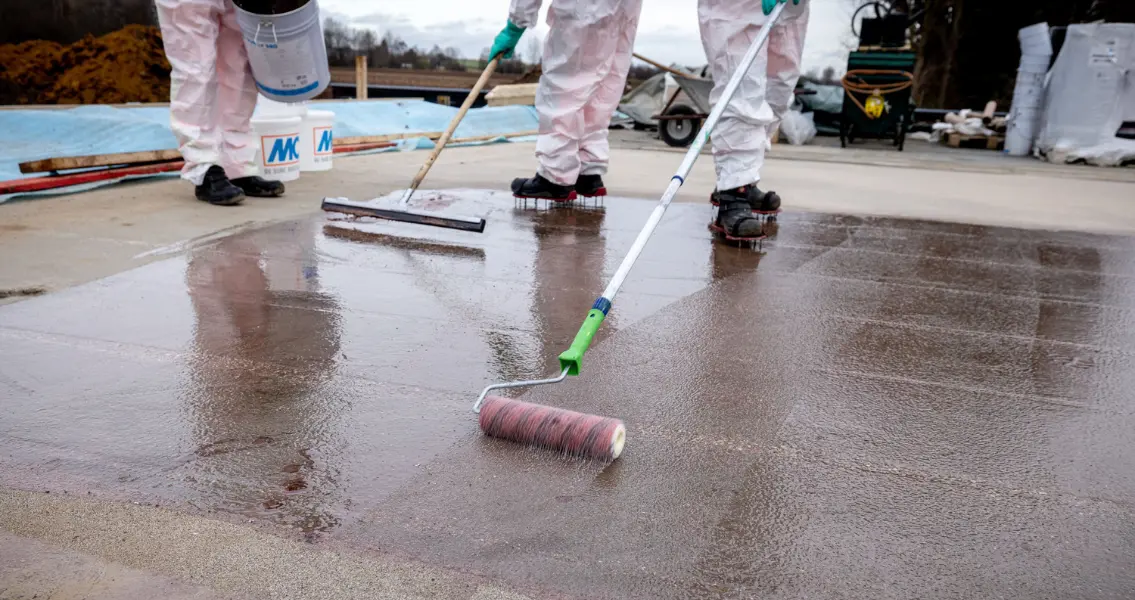

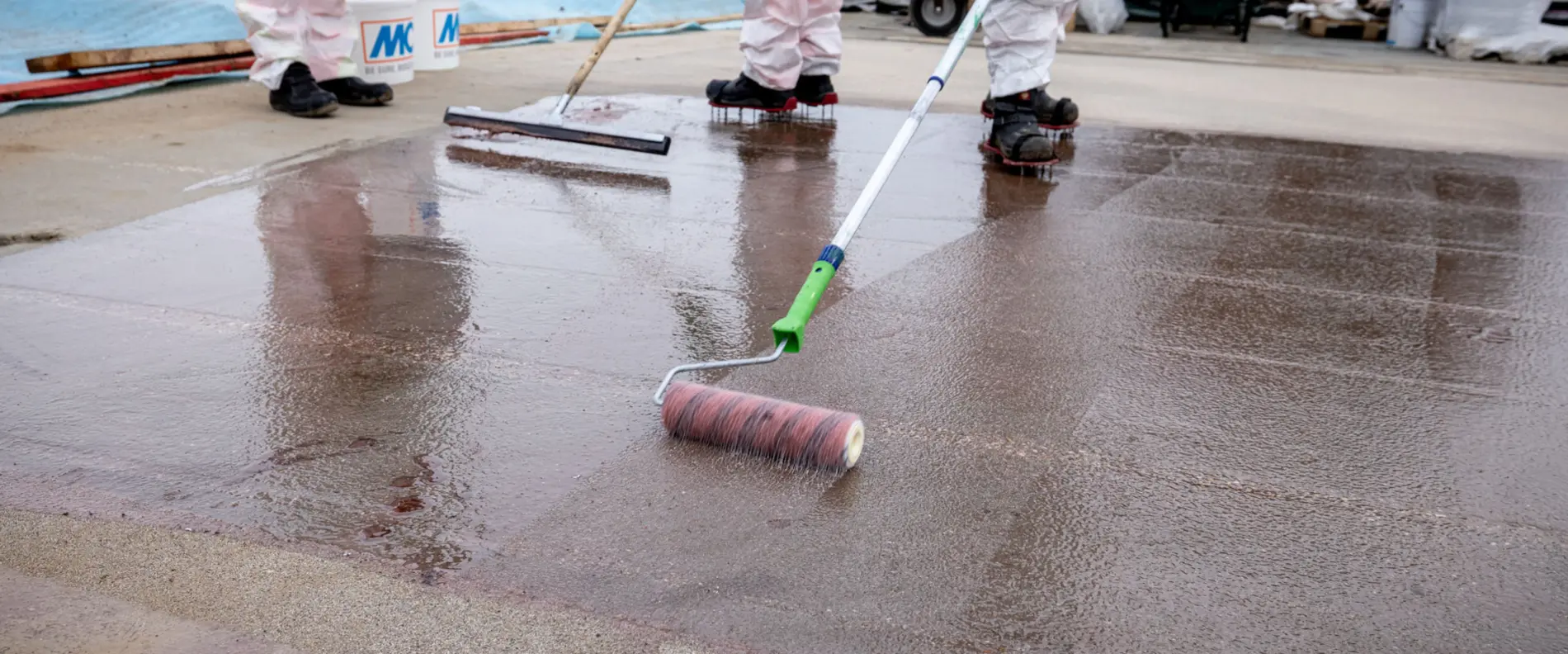

Application of the primer

Application of the primer
© MC-Bauchemie 2025

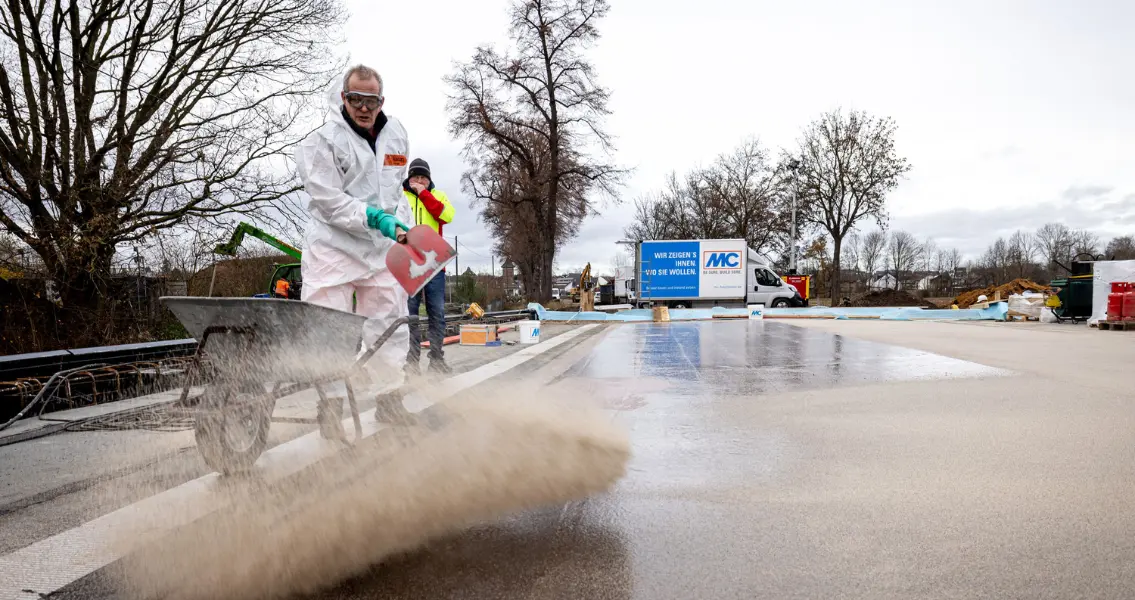

Sanding the primer

Sanding the primer
© MC-Bauchemie 2025

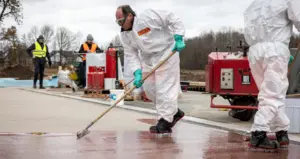

Application of the sealant

Application of the sealant
© MC-Bauchemie 2025

View of the application of the sealant

View of the application of the sealant
© MC-Bauchemie 2025

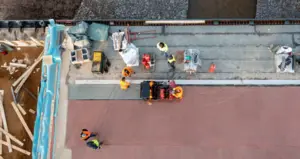

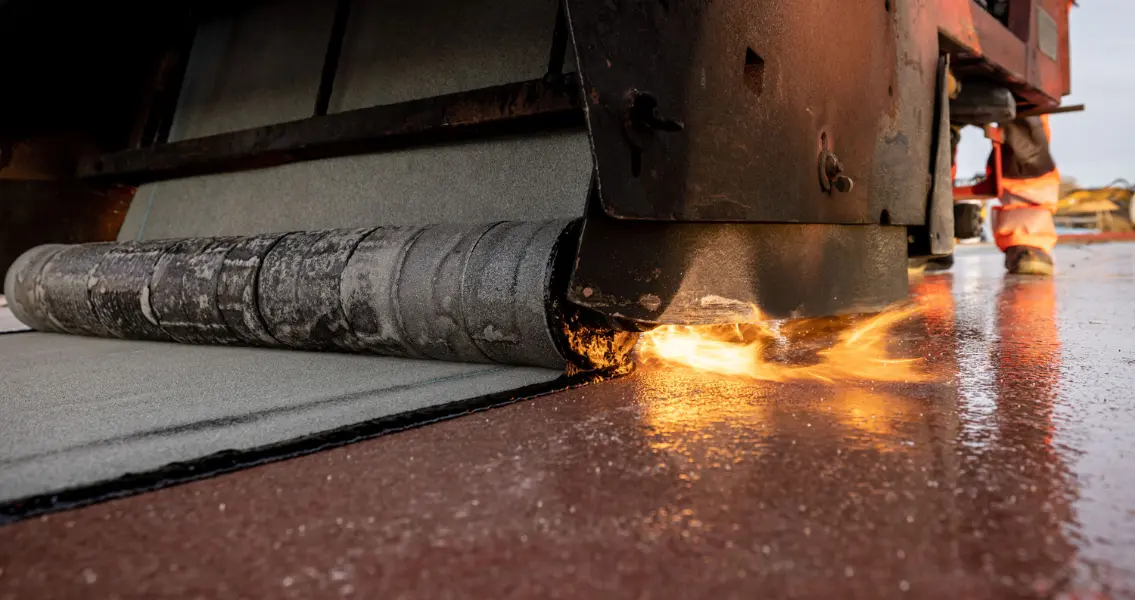

Close-up of the firing of the welding sheets

Close-up of the firing of the welding sheets
© MC-Bauchemie 2025

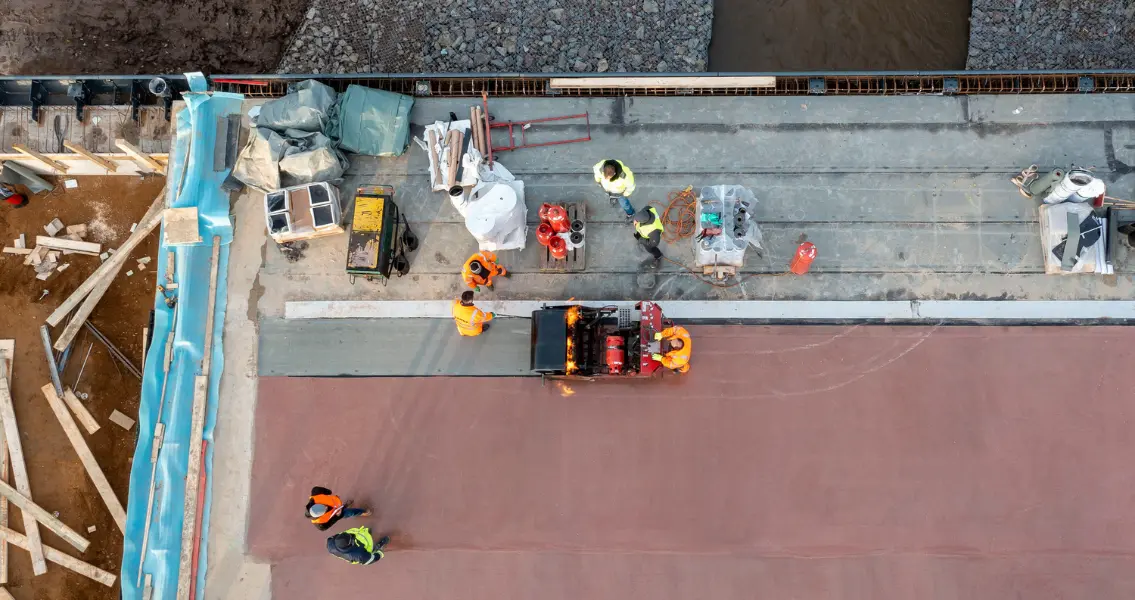

View of the firing of the welding sheets

View of the firing of the welding sheets
© MC-Bauchemie 2025

Huge time savings

The waterproofing work on the new Lommersum bridge in Weilerswist took place on 8 December 2021, with the previously shot-blasted and cleaned surface area of approximately 300 m² being covered in just one day. The situation was similar on the new cycle path bridge over the River Ahrbach in Blankenheim. Here, under the most difficult of conditions, an area of around 60 m² was completely waterproofed from start to finish on 15 December 2021. Both bridges were therefore ready for opening to traffic before Christmas, to the great delight of the residents and all those involved.

Related content

References
Magazine
MC-Pedia
Contact
News
Cookie settings

We are continuously improving our website and we use cookies for this purpose. For an optimal user experience, we recommend that you accept them. Otherwise, parts of the page will be deactivated in the display in accordance with data protection regulations.

Essential

Essential cookies for the website to work properly.

Always active
Analytics

We collect data in order to analyze user behavior on the site. This data will be evaluated to provide a better user experience and make you find what you need faster and easier.

Marketing

We analyze marketing data, for example if you found our site through a marketing campaign. We provide information about success or abandoned carts to better understand if you are interested in a certain product or not.

Comfort

Services that make using our site easier but that are not technically necessary. This includes Google Maps for easy location information, YouTube for embedded videos but also the use of contact forms, which are protected from Spam Using Google ReCaptcha.
